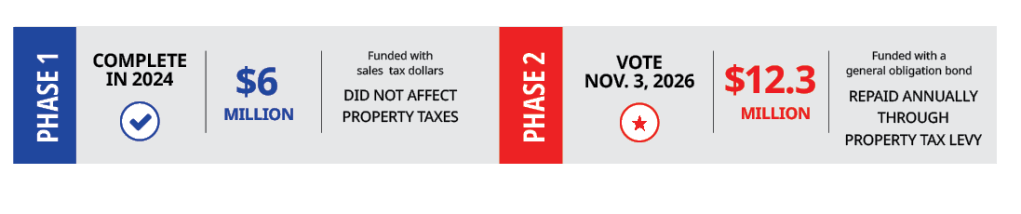

The proposed project is the second phase of a facility master plan presented to the school board by the community-based facility advisory committee in 2022. The first phase – the softball and baseball complex and renovations to the high school science classrooms – cost $6 million. It was paid for using sales tax dollars collected by the state and passed through to school districts. This is often called the penny tax.
This second phase of the project will cost $12.3 million. It will be paid for using a general obligation bond, which is repaid using a debt levy that is just one part of the overall property tax levy the school district uses to pay for a variety of operating expenses. The debt levy can only be used to pay down debt. It can not be used to pay teachers salaries or buy equipment, for example.
THE FINAL PROJECT BUDGET FUNDED BY THE BOND CANNOT EXCEED $12.3 MILLION.

Will this affect my taxes?
The I-35 School District Board has been working to reduce property taxes and will continue to look for ways to save tax payers money.

If the proposed bond passes, it is possible for the district to take on new debt while keeping the overall property tax rate at $16.19. There is always a chance, though, based on a variety of unknown future factors like state law changes or overall property valuations, that the overall tax rate could go up.
If the proposed bond passes, it is possible for the district to take on new debt while keeping the overall property tax rate at $16.19. There is always a chance, though, based on a variety of unknown future factors like state law changes or overall property valuations, that the overall tax rate could go up.

How is the project budget allocated?
Below is how the overall project budget of $12.3 million is approximately split between academic, athletic, and site
projects. It’s important to remember that these are just estimates at this point. Exact figures depend on ongoing
architectural and engineering design and contractor bids, which will all happen after the November 3 election. Once designs are finalized and again when bids are received, we will continue to update the community.
ESTIMATED COST BREAKDOWN
Academics
Reconfigure classrooms and secondary library: $1,468,500
Add air conditioning in kitchen and HS gym: $953,500
Repair cracked tunnel wall: $70,000
Renovate high school restroom: $232,500
Repair elementary school roof: $21,000
Repair exterior walls and gutters: $679,500
Repair existing HS gym bleachers: $14,500
New playground: $917,000
ACADEMIC TOTAL $4,356,500
Site
Reconfigure West Driveway: $141,000
New Parking Lot South of New Stadium: $628,500
Complete Loop Road: $671,500
SITE TOTAL $1,441,000
Athletics
Press box: $251,500
Visitor bleachers: $564,500
Lighting: $622,500
Natural grass field: $889,500
Restroom addition: $924,500
Track: $1,129,000
Home bleachers: $1,200,000
Demolition of existing stadium: $921,000
ATHLETIC TOTAL $6,502,500

Keep in mind the above numbers are all estimates developed by architecture and engineering firms based on past similar projects for other school districts in Iowa. These numbers are project cost estimates, which include labor, materials, fees, etc …
After November 3, the design will be refined and the costs could evolve. Once the design is finalized, the construction will be publicly bid. If bids are lower than the estimates, the project costs are revised down. If bids are higher, adjustments can made to reduce costs or the district can reject the bids and redesign.
THE FINAL PROJECT BUDGET FUNDED BY THE BOND CANNOT EXCEED $12.3 MILLION.
Why is the district rebuilding instead of renovating the stadium?
Everything at the current stadium is past the end of life/use. This means, instead of renovating in the current location, the district would be rebuilding in place. Regardless of location, costs include new home bleachers, visitor bleachers, press box, track, and lighting.
Rebuilding in place is more expensive because if stadium were to stay in the current location, the existing concessions/restroom would need a complete replacement. A new concession/restroom is more than double the cost of adding onto the new restroom/concession building that was constructed as part of Phase 1, with the long-term intent to expand when the stadium was relocated.
It is roughly $1 million more expensive to rebuild the stadium in the current location.
